A power plant worker in a hard hat and hi-vis vest looks over a railing at a modern gas-fired power plant with two exhaust stacks, with high-voltage pylons receding to the right.

Procurement, trading & market designUpdated: 8 min read

StromVKG and the capacity market: the first auction rounds in 2026

With the Electricity Supply Security and Capacity Act, Germany launches its first genuine capacity market in 2026. What is sold is no longer just electricity, but the reliable availability of capacity for the dark doldrums.
Summary

The Electricity Supply Security and Capacity Act (StromVKG) introduces a central capacity market in Germany. It pays for the reliable availability of generation capacity, not only for electricity delivered. The Bundestag passed the act on 9 July 2026, the Bundesrat let it through on 10 July, and it has been in force since 22 July 2026. The delivery year starts in 2031. It starts with two auctions for long-term capacity, bid deadlines 8 September and 29 December 2026, 4.5 gigawatts each, 9 gigawatts in total. According to the Bundesnetzagentur, the first round was clearly oversubscribed, with awards due by 3 November 2026. Participation is fully digital via the Bundesnetzagentur's Closed User Group platform, where registration and authentication for the first deadline had to be in place by 1 September 2026. Long-term capacity requires at least ten consecutive hours of full output, which in practice admits only gas plants and excludes battery storage in the first phase. Only from May 2027 can batteries and controllable loads bid. For power plant operators, utilities and flexibility providers, one thing matters most now: set up registration, prequalification and the data household so that a bid can be submitted on time and audit-proof.

8 Sep + 29 Dec
bid deadlines 2026
long-term capacity, two rounds
4.5 GW each
auction volume
9 GW total in 2026
1 Sep 2026
GBG registration deadline
closed for round one
10 hrs
minimum full output
long-term capacity requirement
from 2031
delivery year
availability is paid
550 g
CO2 per kWh cap
fossil fuels, all products

What the StromVKG regulates and why now

The StromVKG introduces a central capacity market. In future, it pays not only for the electricity delivered but for the reliable availability of capacity for times when wind and solar are scarce. The Bundestag passed the act on 9 July 2026, the Bundesrat let it through on 10 July, and it has been in force since 22 July 2026. The delivery year starts in 2031.

For you as an operator or utility, this creates a second revenue stream alongside the energy market. Whoever offers guaranteed availability receives an annual capacity payment, but must actually deliver that capacity when it matters. The capacity market is therefore not a subsidy pot but a market model with clear obligations.

  • Its predecessor, the Power Plant Security Act (KWSG), never entered into force. How the StromVKG grew out of it is covered in the article on H2-ready power plants and the path from KWSG to StromVKG.
  • The goal is a predictable revenue regime that incentivises investment in dispatchable backup capacity as coal and nuclear are phased out.
  • The capacity market complements the energy market, it does not replace it. Both revenue streams run in parallel and must be considered together in the portfolio.

The first auction rounds in 2026

The market starts in 2026 with two auctions for long-term capacity. The bid deadlines are 8 September 2026 and 29 December 2026 (section 4(1) StromVKG; the government draft still had 22 December), tendering 4.5 gigawatts of reduced output each, 9 gigawatts in total. The Bundesnetzagentur reported on 9 September that the 8 September round was clearly oversubscribed; it announces the awards by 3 November 2026 and publishes the second bid deadline on 10 November 2026. If the volume is not fully awarded, a third bid deadline follows on 18 May 2027.

Timeline of the StromVKG auction roadmap with the bid deadlines in September and December 2026, May 2027, the 2027 and 2029 rounds and the delivery year from 2031.
The StromVKG auction roadmap. The two long-term capacity rounds in 2026 are followed by the battery-eligible round in May 2027 and the general capacity auctions in 2027 and 2029, before the delivery year begins in 2031.
  • Awards are made pay-as-bid to the lowest offers, with a minimum bid of 1 megawatt of reduced output.
  • A south quota and a south bonus steer awards specifically to sites near grid bottlenecks in the south.
  • The term of long-term capacity is 15 years from award, coupled with an obligation to reach climate neutrality by 2045.

Three capacity products, one timeline

The StromVKG defines tiered products with different requirements and terms. The first rounds are tailored to long-term capacity, later rounds open the market to other technologies. Anyone wanting to take part must first know which product fits their plant.

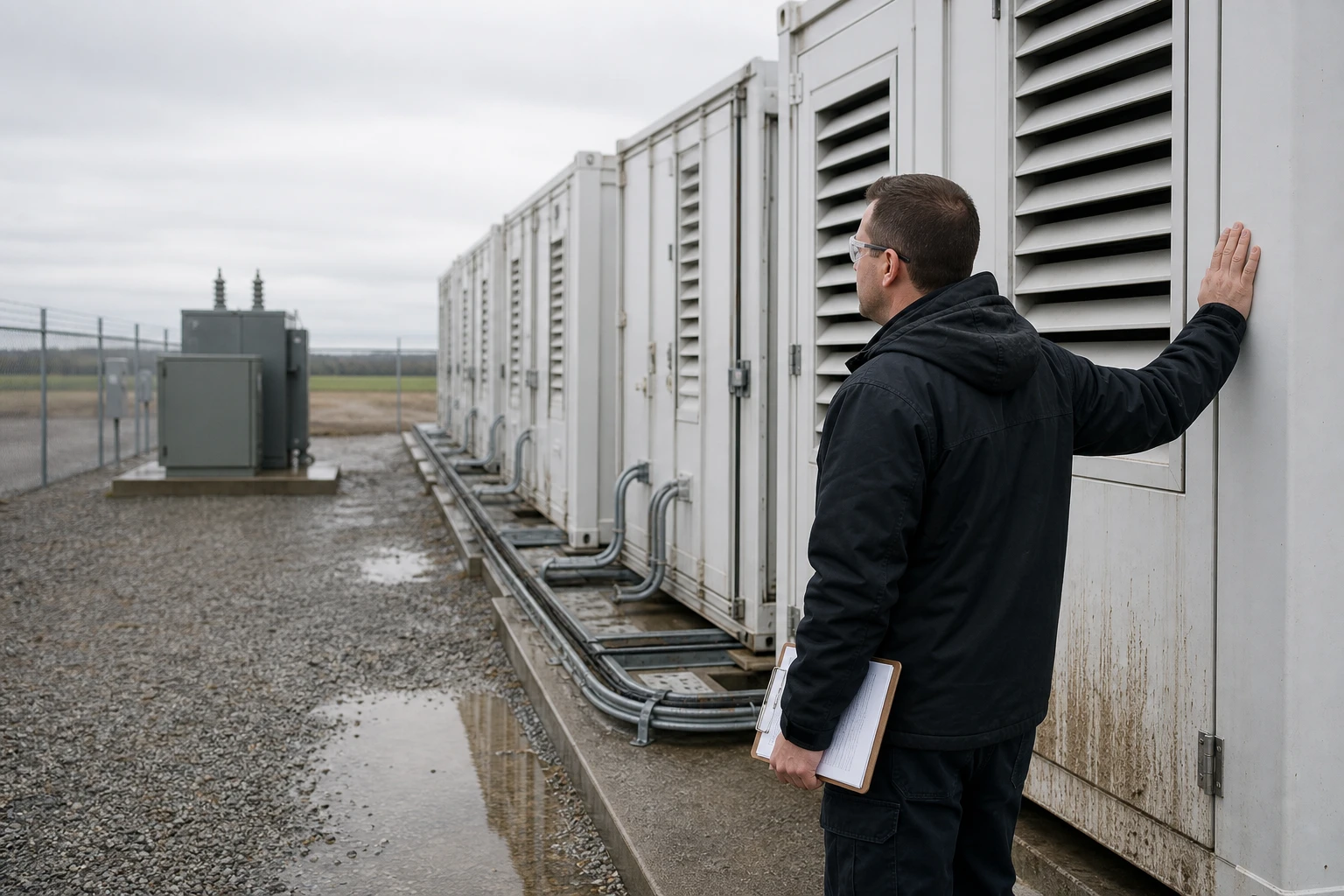

A technician with a clipboard stands at a row of white battery storage containers on a fenced gravel lot, with a transformer and flat field in the background.
Battery storage stays out of the first 9-gigawatt phase. Only from the generation-capacity round in May 2027 can it bid.
  • Long-term capacity: at least ten consecutive hours of full output, 15-year term, starting in 2026. In practice, gas plants dominate here.
  • Generation capacity: all generation types, 2 gigawatts at the 18 May 2027 bid deadline, open to battery storage as well.
  • Capacity: generation, controllable loads and pools, terms of 1, 7 or 15 years, bid deadlines 1 December 2027 and 1 October 2029.
  • All products face an emissions cap of no more than 550 grams of CO2 from fossil fuels per kilowatt-hour.

Why gas plants dominate the first rounds

The ten-hour rule and several additional requirements filter battery storage out of the first phase. Critics see this as a technological pre-decision in favour of gas, even though the capacity market is meant to be technology-neutral.

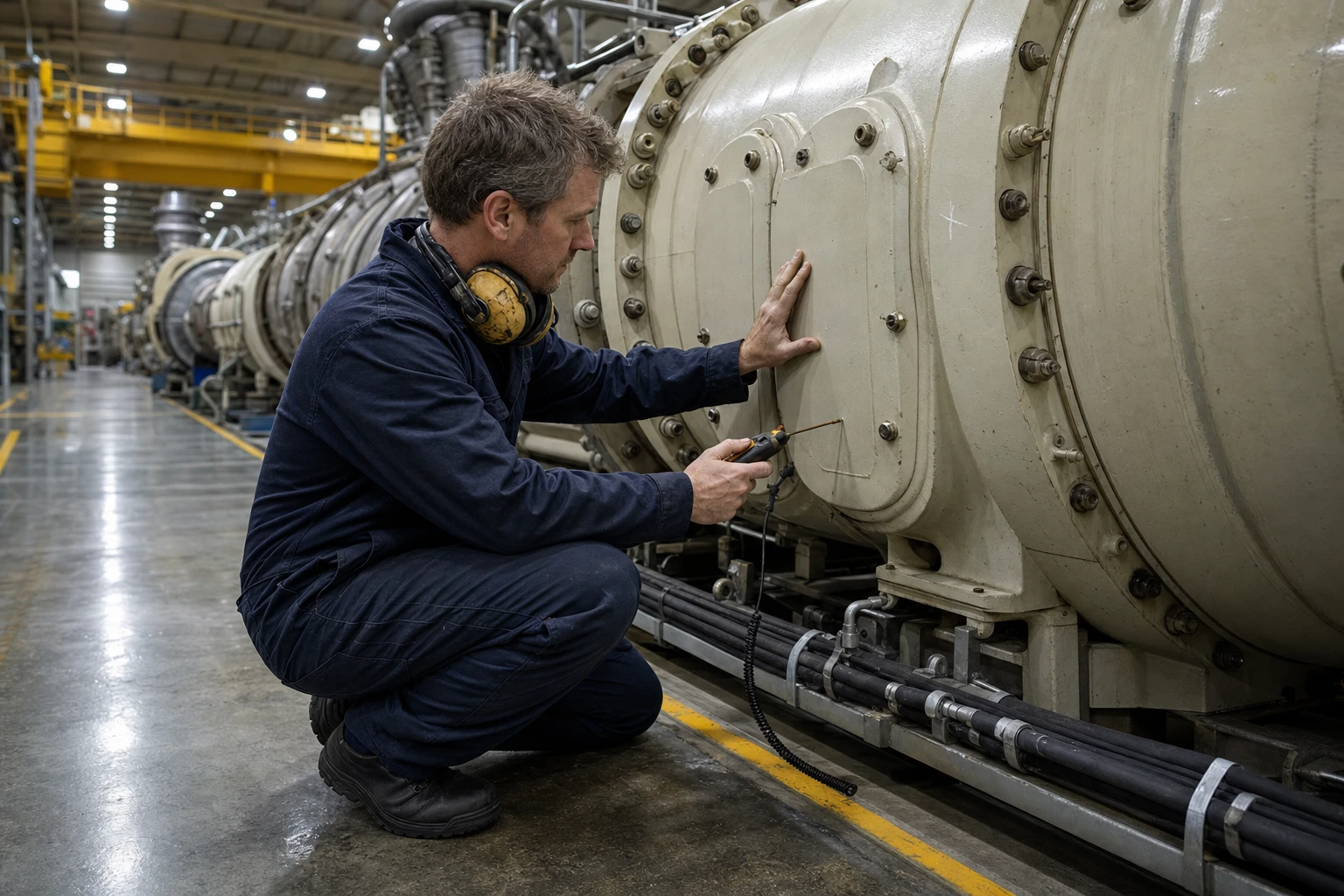

A technician with ear defenders kneels in a power plant hall beside the pale casing of a large gas turbine, checking it with a handheld probe.
Gas plants are the assets able to deliver ten hours of constant full output. That very requirement decides the first auctions.
  • Storage must be able to restore the ten-hour output at any time with no more than one hour of lead time, which effectively excludes energy-limited batteries.
  • 15-year bids additionally require at least 50 percent of resilience-relevant components to originate from the European Economic Area. For battery cells, most come from China in 2026.
  • Hybrid pools of gas plant and battery are prohibited in the long-term and generation auctions. How storage earns money in the market otherwise is covered in the article on grid-scale storage and data centres.
  • A study by the think tank Epico concludes that 5 gigawatts of gas capacity would suffice through 2035, while 9 gigawatts are reserved for long-term capacity alone.

The digital bidding process

The entire participation runs digitally. Whoever registers too late or fails to prepare the required evidence cleanly cannot bid. That makes bidders' process maturity as decisive for the award as the bid price.

Bids are submitted only through the Bundesnetzagentur's electronic Closed User Group (GBG) platform. For the first bid deadline, bidder authentication and registration for the GBG had to be completed by 1 September 2026 inclusive. Anyone who missed that cut-off could not bid in round one, however competitive their bid would have been.

  • Prequalification is carried out by the transmission system operators, in the long-term and generation capacity rounds only after the award (Section 25(4) and (5) StromVKG). A grid connection confirmation and the exclusion of double funding under the EEG or CHP Act are prerequisites.
  • By the bid deadline, bidders lodge a bid security of 15 percent of the maximum value. In the long-term and generation auctions that ceiling is 244,000 euros per megawatt of reduced output per year, so the security comes to 36,600 euros per megawatt.
  • Longer terms come with investment thresholds: around 201,000 euros per megawatt for seven years and around 431,000 euros per megawatt for fifteen years.

Prequalification: platform by May 2027, completion by October 2031

For the two rounds in 2026 and the generation round on 18 May 2027 there is no prequalification before the bid. Bidders include the details of a provisional prequalification in the bid itself and complete it only after the award (Section 25(4) and (5) StromVKG). At the bid date of 1 December 2027 prequalification also remains provisional, because only plant details without evidence are required (Section 25(3)). Every award from the rounds up to December 2027 therefore depends on two dates: the launch of the platform through which completion runs, and 31 October 2031, by which completion must be applied for.

1 May 2027: the transmission system operators open the joint platform

In agreement with the Bundesnetzagentur, the transmission system operators set up a joint web platform, for prequalification by 1 May 2027 and for capacity tenders by 15 October 2027 (Section 26(6) StromVKG). Bidders file their prequalification application through it, no earlier than the first day of the seventh month and no later than the first day of the fifth month before the bid date (Section 26(2)). For the bid date of 1 December 2027 that works out to a window from early May to early July 2027, so the platform has to be running when the window opens. The transmission system operators also publish the format requirements for data, evidence and self-declarations there (Section 26(7)), and only with those requirements can the export from your own plant master data be built.

Section 26 names no consequence for a late launch; the duty lies with the transmission system operators. What counts for bidders is the window: outside it the application cannot be filed, and without prequalification there is no bid in a capacity tender (Section 25(1)).

31 October 2031: application to complete provisional prequalification

Anyone awarded capacity on the basis of provisional prequalification submits the application to complete it, with the data and evidence under Section 62, to the responsible transmission system operator via the joint platform by the end of 31 October 2031 at the latest (Section 61(2) StromVKG). The security for compensation payments and for the penalty under Section 44 is lodged with the application (Section 61(1)). Some operational evidence, such as proof of installed capacity from three months of quarter-hourly load profile data, may follow by 31 January 2032. The transmission system operator normally decides within eight weeks; if the security follows together with that evidence, by 31 March 2032 at the latest (Section 63(1)).

Plant pools face a metering duty on the same date: by the end of 31 October 2031 every plant in a pool must have a smart metering system under the Metering Point Operation Act and be load-profile metered (Section 21(2) StromVKG). A small-plant pool made of plants below 1 megawatt means many metering points, each needing a metering point operator that has completed the installation by then. Pool operators should therefore agree installation dates early with the default or a competitive metering point operator.

Completion must be refused, among other cases, if the application was not filed "within the relevant deadline" or if the requirements are not fully met by 1 November 2034 for a 15-year commitment period or by 1 November 2033 for a 7-year one (Section 63(3) StromVKG). With the refusal the award lapses (Section 53 sentence 1 no. 4). For awards covering more than one commitment year the non-realisation penalty comes on top: the bid reduced capacity times the bid value, or times 1.5 times the bid value for plants subject to the 15-year investment threshold. Anyone who only overruns the Section 61(2) deadline pays a share of it, one twelfth for a delay of up to two months and the full amount after more than 14 months (Section 64 StromVKG).

German and EU perspective

Germany is introducing a capacity market later than many of its neighbours. Belgium, the United Kingdom, Poland and Ireland have long run technology-neutral models with battery participation. The German approach is therefore seen as late, but also as unusually narrowly tailored to gas plants.

Financing runs through a levy, not the federal budget. Details on the amount and its distribution are to follow in a separate Capacity Market Act in 2027. The capacity market feeds into the same market processes as the controllable tariffs described in the article on tariff models in 2026.

  • The European Commission granted state-aid approval on 2 September 2026, six days before the first bid deadline.
  • 15-year contracts require climate neutrality by 2045, including proof that the plant can be converted to hydrogen.
  • A separate hydrogen programme targets the conversion of 4 gigawatts of gas capacity, with a first auction by the end of 2027.

Challenges and risks

The capacity market secures supply, but it creates costs and locks in technology paths for a long time. On balance, the gain in predictability is offset by a price risk and a long commitment.

  • Higher costs than necessary: reserving 9 rather than the 5 gigawatts estimated by Epico raises backup costs. The levy weighs on electricity prices from 2031.
  • Technology lock-in: 15-year commitments cement infrastructure decisions through 2041 and make later corrections harder.
  • Market access for storage: domestic battery manufacturers lose market access in the first phase despite investing billions. How storage holds its own in the market is covered in the article on virtual power plants.
  • Competition concerns: established utilities benefit from secured investment frameworks, which can reinforce market concentration.

What companies should do now

Power plant operators and utilities should set up process and data household now, not just when the deadline looms. Treating registration as a formality risks being unable to bid at all on 29 December 2026. Four steps take priority.

Four priority steps

  1. Start GBG registration

    For round one, authentication closed on 1 September 2026. Anyone bidding on 29 December 2026 completes authentication and registration for the BNetzA platform early and meets the cut-off set in the notice for the second deadline, which the Bundesnetzagentur plans to publish on 10 November 2026.

  2. Prepare prequalification

    Align documents with the transmission system operator: grid connection, emissions proof and the exclusion of double funding must be robustly documented.

  3. Anchor the bidding strategy in the portfolio

    Choose sites with an eye on the south quota and weigh the 1, 7 or 15-year term against the investment thresholds. Consider capacity and energy market together.

  4. Prepare storage for 2027

    Storage and flexibility operators plan for the rounds from May 2027 and factor the EEA component quota into procurement and supply chains early.

The capacity market is one building block of the digital energy transition, not a standalone topic. It feeds into the same digitalisation as congestion management, described in the article on Redispatch 3.0. Only market design, bidding process and grid control together form a complete picture.

Deadline, market roles, systems

1 May 2027Capacity market: TSO platform for prequalification by 1 May 2027Law · adopted

If the deadline is missed: No direct legal consequence Section 26 StromVKG states no specific consequence of a late platform launch. Legal basis ↗

  • Transmission system operatorrole obligationSets up the joint platform for prequalification by 1 May 2027 and for tenders by 15 October 2027.Typically affected: Customer and grid connection portal, Regulatory management, controlling
  • Plant operator (generation)affectedPrepares prequalification of generation and storage plants on the platform.Typically affected: Plant master data and MaStR, Regulatory management, controlling

31 October 2031Capacity market: apply to complete provisional prequalification by 31 October 2031Law · adopted

If the deadline is missed: Exclusion or loss of role Without a timely application the TSO refuses to complete the provisional prequalification (Section 63(3) StromVKG). The award then lapses (Section 53 sentence 1 no. 4), and for commitment periods of more than one year the non-realisation penalty is owed to the TSO (Section 64(1)). Legal basis ↗

  • Direct marketeraffectedPlans smart metering for plant pools by 31 October 2031.Typically affected: Direct marketing and remote control
  • Plant operator (generation)role obligationApplies to complete prequalification by 31 October 2031 and equips pool plants with smart metering and load profile metering.Typically affected: Plant master data and MaStR, Regulatory management, controlling

A classification for typical market roles, not a review of your individual case and not legal advice. Whether an obligation applies to your company (thresholds, exemptions) is for your legal department or counsel to confirm. The calendar doesn't replace your own deadline review. Information as of: 1 November 2026.

Discuss the implementation →In the deadline calendar →
