Technician at an open meter cabinet on a house wall in a quiet residential street at dawn, a symbol of the smart meter installation

Smart Meter Rollout 2026: The Stalled Data Base for the AI Grid

Without widespread intelligent metering systems, AI-driven control of the power grid stays theoretical. By the end of 2025 penetration stood at 5.5 percent, and 2026 becomes the year of pressure.

Smart meters supply the high-resolution consumption data that load forecasting, congestion control and dynamic tariffs rely on. In Germany that base is largely missing. In March 2026 the federal regulator opened 77 supervisory proceedings against lagging metering operators for the first time, while a technical study judged the planned mass rollout unfeasible. This article sets out the figures, explains the gateway and section 14a, and shows what municipal utilities, grid operators and larger consumers should do now.

Summary

The smart meter rollout decides whether AI can control the German power grid, because intelligent metering systems supply the 15-minute consumption data on which load forecasting, congestion control and dynamic tariffs depend. Yet by the end of 2025 only around 3.1 million smart meters were installed, about 5.5 percent of 56.5 million metering points, and among the mandatory cases only about one fifth had been equipped. On 27 March 2026 the Bundesnetzagentur opened 77 supervisory proceedings against metering operators that missed the 20 percent quota, while a Horizonte Group study judged the 2026 mass rollout technically unfeasible. The smart meter gateway, certified by the Federal Office for Information Security, is the encrypted data hub between household, grid operator and supplier and the basis for control under section 14a EnWG. For companies the order is clear: first build clean, interoperable metering data, then use AI applications and dynamic tariffs.

Why the stalled meter swap is an AI problem

The smart meter rollout decides whether AI can control the German power grid. Intelligent metering systems supply the high-resolution consumption data on which load forecasting, congestion control and dynamic tariffs are built. By the end of 2025, however, penetration stood at 5.5 percent, and the backlog is becoming the bottleneck for digitalising the energy transition.

5.5 %
smart meter penetration
around 3.1m of 56.5m metering points, end 2025
77
regulator proceedings
opened on 27 March 2026
about 20 %
of mandatory cases equipped
quota by end 2025
15 min
interval instead of annual reading
basis for forecasting and tariffs
813
metering point operators
many small municipal utilities
95 %
target for mandatory cases by 2030
schedule of the Metering Operation Act

The link is simple: AI models for the grid and the market need metering data in 15-minute intervals. Without a meter base they lack the input and stay blind across large parts of the grid. How AI helps catch load peaks in an emergency is covered in innobu's article on AI-driven blackout prevention . The precondition for it is the data base discussed here.

What a smart meter can do and how the gateway works

An intelligent metering system consists of a modern metering unit plus the smart meter gateway , the communication unit certified by the Federal Office for Information Security . The gateway encrypts the readings and distributes them to authorised market participants. It is the data hub between household, grid operator and supplier.

Intelligent metering system (iMSys) is the legal term for a smart meter made up of a modern metering unit and a smart meter gateway. It measures electricity use in 15-minute intervals and can send the values, encrypted, to the grid operator, the supplier and other authorised parties.
Flow diagram: metering data moves from the smart meter through the BSI gateway, encrypted, to grid operator and supplier for AI control and dynamic tariffs
The smart meter gateway is the encrypted hub: it carries the metering data to grid operator and supplier, which turn it into AI load forecasting, section 14a control and dynamic tariffs.

The security-critical component is the gateway. Certification by the Federal Office for Information Security, with requirements at a high security level, delayed the market launch for years. That protection is justified, because 15-minute profiles are sensitive data, but it adds complexity and therefore installation cost.

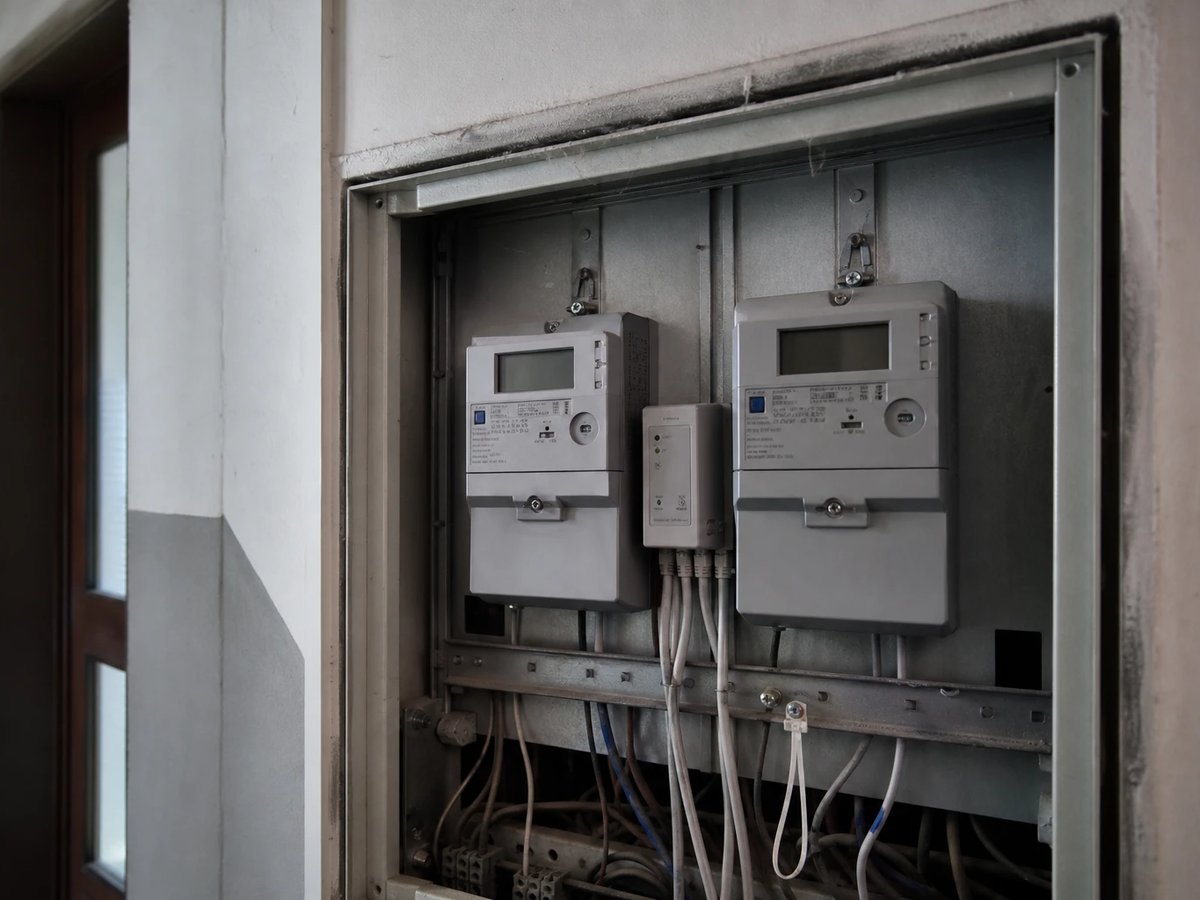

Open meter cabinet with two modern digital electricity meters and a grey communication module with cabling
Inside the meter cabinet: two modern digital metering units and the separate communication module that turns the meter into a full intelligent metering system.

The use cases reach well beyond billing. The gateway's data base supports dynamic tariffs, grid-friendly control under section 14a, integration into virtual power plants and, in time, the bidirectional charging of electric cars.

The mandatory schedule: who gets a meter when

The Metering Operation Act obliges the basic metering point operators to roll out in stages. Mandatory cases are consumers above 6,000 kilowatt hours of annual use and generation systems above 7 kilowatts, so many households with photovoltaics or a heat pump. Since 2025 any household can also actively request installation.

by end 2025

20 percent of mandatory cases

First stage of the schedule. Met in aggregate, but many individual operators stayed below it, which triggered the proceedings.

by 2028

50 percent of mandatory cases

Second stage. Assumes that market communication and back-office processes are noticeably automated by then.

by 2030

95 percent of mandatory cases

Near-complete coverage of the mandatory cases. The optional installation group follows by 2032.

since 2025

Installation on request

Any household can request early installation, with a deadline of around four months at the basic metering point operator.

The obstacle lies in the structure. Across Germany 813 metering point operators are responsible, many of them small municipal utilities without enough IT and staff. This fragmentation explains why the same duty is met very differently from region to region.

German perspective: the regulator acts, a study brakes

On 27 March 2026 the Bundesnetzagentur opened 77 supervisory proceedings against metering operators that, despite warnings, had installed no or too few meters. At the same time a technical study warns that the planned mass rollout for 2026 cannot be achieved. Both show the tension between political pressure and real feasibility.

Smart meter installation plays a central role in digitalising our power system. The agency is pursuing implementation with determination.

Klaus Müller, President of the Bundesnetzagentur, paraphrased on the opening of proceedings

The agency threatens penalty payments and has announced further proceedings against smaller operators. On the other side, the Horizonte Group technical study from November 2025 concludes that the mass rollout for new systems in 2026 is technically not feasible. It cites back-office bottlenecks and a lack of interoperability between IT systems.

Fax meets AI agent : How deep the fragmentation runs is shown by one example from practice. A modern provider already files transactions through a software agent, while at the counterpart the same request lands in a fax machine. The rollout therefore depends less on the devices than on market communication between the parties.

Section 14a and dynamic tariffs: what the data is for

Smart meters are the precondition for grid-friendly control and time-variable prices. Section 14a EnWG allows grid operators to dim controllable loads such as heat pumps and wallboxes to 4.2 kilowatts during a bottleneck instead of switching them off. In return grid fees fall through three modules.

Module 1

Flat reduction of grid fees, roughly 110 to 190 euros per year depending on the grid. Mandatory for new controllable devices.

Module 2

Percentage reduction of the grid fee energy price by 60 percent. Rules out combining it with module 3.

Module 3

Time-variable grid charges with a low, standard and high-load tariff. Grid operators have had to offer this module since April 2025.

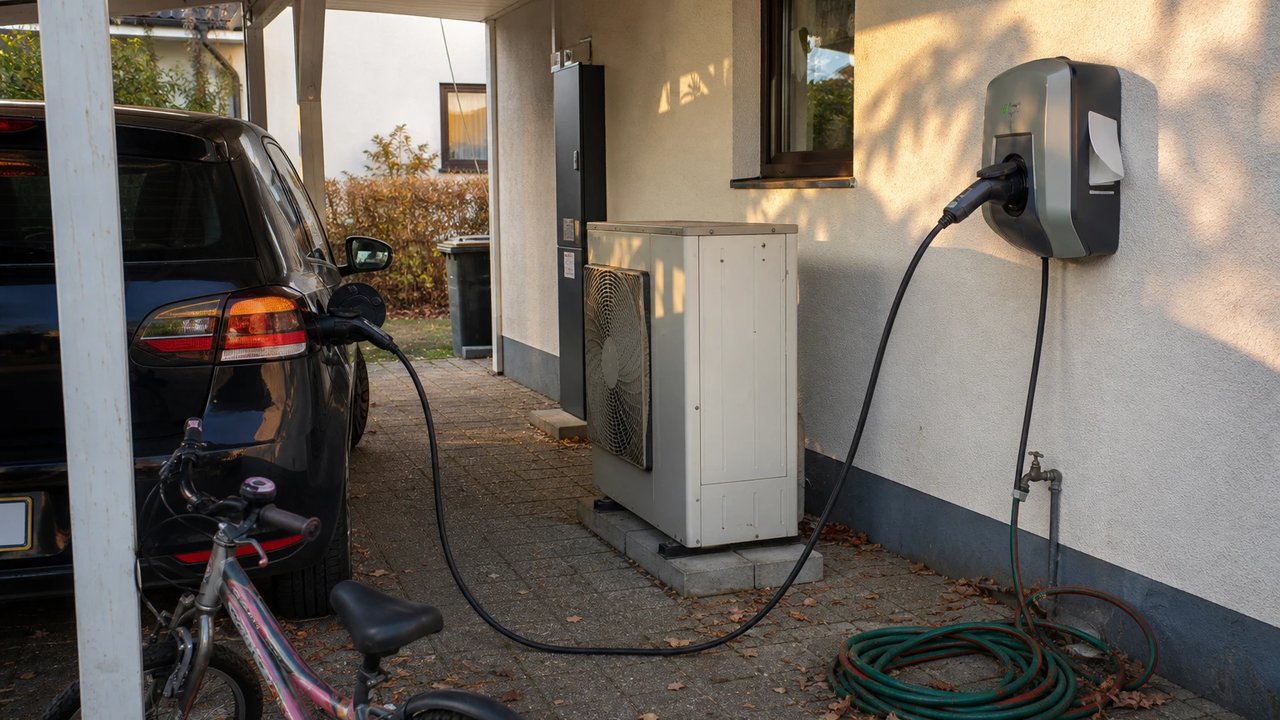

Wallbox on a house wall charging an electric car, next to a heat pump and a meter cabinet, the typical controllable loads under section 14a
Heat pump and wallbox are the controllable loads that section 14a dims during a bottleneck. Only the smart meter makes the needed measurement and control possible.

On the supplier side too the data hangs on the meter. Since 2025 electricity suppliers have had to offer at least one dynamic tariff that tracks the hourly spot market price. Such tariffs require an intelligent metering system. The nationwide spread between the standard and low tariff in 2026 averages 5.1 cents per kilowatt hour net, a real incentive to shift consumption into cheaper hours.

Where AI uses the data and where the limits are

Once the data is available, AI does concrete work in the distribution grid. Studies report load forecasts with an error below two percent. At the same time technology alone does not solve the control problem, and dynamic prices in particular have a downside.

1

Load forecasting

Short-term prediction of consumption and generation from weather, real-time data and history. Reported error rates fall below two percent.

2

Congestion detection

Models predict local grid bottlenecks and estimate where and how much flexibility is needed to avoid them.

3

Anomaly and loss

Detection of metering errors, technical losses and unusual patterns up to manipulation, based on the meter profiles.

4

Topology

Inference of the actual grid structure from metering data where plans are incomplete, as a basis for planning and control.

5

Flexible loads

Integration of heat pumps, wallboxes and storage into control, and their aggregation into virtual power plants.

6

Market optimisation

Matching consumption and spot price so that dynamic tariffs and self-generation work together sensibly.

A critical voice from research: Fraunhofer IEE warns that purely market-driven dynamic prices do not address local grid bottlenecks and can even amplify synchronisation effects. If every wallbox charges in the same cheap hour, a new load peak appears. AI on metering data and local grid signals must therefore work together, not the market price alone.

Challenges and risks

The rollout depends on organisation, not only on technology. Fragmentation, manual processes and a dispute over market structure brake it more than the devices themselves. An honest balance shows what already holds and what is still missing.

What already holds
The legal framework and mandatory schedule are fixed
Gateway technology and certification are available
Dynamic tariffs and section 14a modules are in force
What is still missing
Penetration at only 5.5 percent by end 2025
Missing interoperability, some processes by fax
Risk of new load peaks without local grid signals

On top comes the political dispute over market structure. A proposal to concentrate the rollout more with the basic operator prompted more than 36 companies and associations to issue a joint warning against re-monopolisation. Data protection and IT security remain a standing task, because 15-minute profiles allow deep insight into a daily routine, which in Europe falls under the GDPR .

What companies should do now

Municipal utilities, grid operators and larger consumers should treat the backlog as a plannable project, not a tick-box duty. Whoever builds the data base early can use AI applications and dynamic tariffs first. Four steps help you prepare.

  1. Align the rollout with the schedule

    Metering operators should align their installation plan clearly with the quotas for 2028 and 2030 and prioritise the mandatory cases with high consumption and generation.

  2. Automate market communication

    The biggest lever sits in the back office. Replacing manual and paper-based processes with interoperable interfaces lifts the real bottleneck of the rollout.

  3. Data strategy before AI project

    Without clean, interoperable metering data every AI load forecast stays theoretical. Data quality, access rights and data protection belong at the start, not the end.

  4. Let consumers take the initiative

    Industry and commerce above 6,000 kilowatt hours should request installation actively and check load flexibility and the section 14a modules for their benefit.

Key point

In 2026 the smart meter rollout is no longer a mere duty but the precondition for any serious AI control in the grid. Whoever orders the meter base and market communication now can use load forecasting, congestion control and dynamic tariffs as soon as the data flows. How AI is changing the distribution grids in the DACH region is explored in the article on the Digital Grid Insights and the digitalisation of distribution networks .

Further reading

Frequently asked questions

What is a smart meter and what is a smart meter gateway? +

A smart meter, called an intelligent metering system or iMSys in German law, consists of a modern digital metering unit plus the smart meter gateway. The gateway is the communication unit certified by the Federal Office for Information Security. It measures consumption in 15-minute intervals, encrypts the values and distributes them to authorised market participants such as the grid operator and supplier.

How many smart meters are installed in Germany? +

By the end of 2025 around 3.1 million intelligent metering systems were installed, about 5.5 percent of roughly 56.5 million metering points. Around half of all meters are digital, that is modern metering units, but without a gateway and therefore not able to communicate. Among the legally defined mandatory cases only about one fifth had been equipped by the deadline.

Who must have a smart meter installed? +

The Metering Operation Act obliges the basic metering point operators to install meters for consumers above 6,000 kilowatt hours of annual use and for generation systems above 7 kilowatts, for example households with photovoltaics or a heat pump. Since 2025 any household can also actively request installation, with a deadline of around four months.

What does section 14a EnWG have to do with smart meters? +

Section 14a EnWG allows grid operators to dim controllable loads such as heat pumps and wallboxes to 4.2 kilowatts during a grid bottleneck instead of switching them off. The precondition is an intelligent metering system. In return grid fees fall: through a flat reduction, a percentage reduction, or since April 2025 through time-variable grid charges in module 3.

Why does the rollout hold back AI in the power grid? +

AI models for load forecasting, congestion detection and the control of flexible loads need metering data in 15-minute intervals. Without widespread smart meters this input is missing, and the models stay blind across large parts of the grid. At 5.5 percent penetration by the end of 2025 the data base for broad AI-driven grid control does not yet exist.
